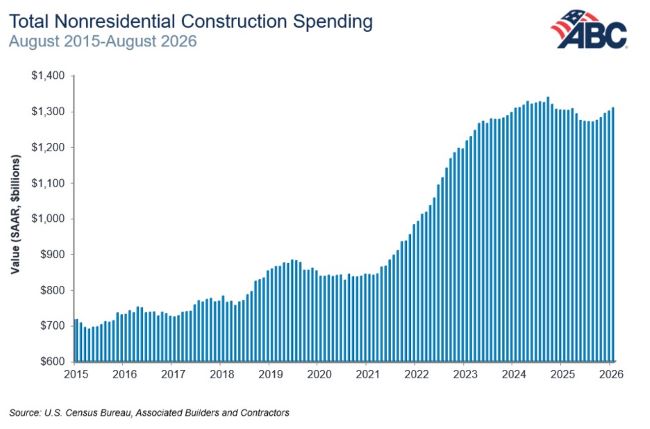

National nonresidential construction spending increased 0.7% in August, according to a new analysis by Associated Builders and Contractors (ABC) of data published by the U.S. Census Bureau. On a seasonally adjusted annualized basis, nonresidential spending totaled $1.309 trillion.

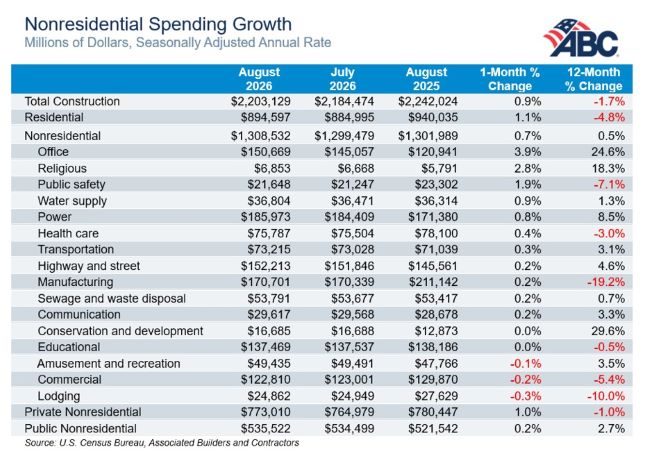

Spending was up on a monthly basis in 11 of the 16 nonresidential subcategories. Private nonresidential spending was up 1.0%, while public nonresidential construction spending was up 0.2%.
“Nonresidential construction spending increased for the fifth consecutive month in August as data center investment accelerates,” said ABC Chief Economist Anirban Basu. “Frankly, it’s becoming difficult to contextualize the size and speed of this boom. Data center construction spending leapt another 7.5% in August and is now up more than 73% over the past 12 months. The increases have been particularly large over the past four months, with data center spending increasing at an incredible 149% annualized pace since March.
“While momentum remains particularly concentrated in the data center segment, several other segments posted surprisingly strong spending growth in August,” he continued. “Manufacturing construction activity, for instance, expanded on a monthly basis for the first time since January, while several public categories grew at a steady, albeit unspectacular, pace.
“Despite this broad improvement, momentum will likely remain confined to the data center and power categories in the months to come,” Basu noted. “Materials and labor cost escalation have reemerged during the second half of 2026, and the recent surge in Treasury yields will continue to put upward pressure on borrowing costs. ABC members remain optimistic about the sales outlook, according to ABC’s Construction Confidence Index, yet those sales will increasingly be in a narrow subset of construction categories.”
Visit abc.org/economics for the Construction Backlog Indicator and Construction Confidence Index, plus analysis of spending, employment, job openings and the Producer Price Index.

About Associated Builders and Contractors
Associated Builders and Contractors (ABC) is a national construction industry trade association established in 1950 with 67 chapters and 24,000 members. Founded on the merit-shop philosophy, ABC helps members offer a robust employee value proposition, develop people, win work, and deliver that work safely, ethically and profitably for the betterment of the communities in which ABC and its members work.
